Pipe Installation and Civil Works

Installation methods, route planning, and civil engineering for thermal networks: burial, trenchless methods, and construction workflow

What you will learn in this article:

  • Above-ground, buried, and trenchless installation
  • Route planning and minimum clearances
  • Construction workflow and installation situations
Table of Contents

Pipe installation including civil works accounts for 50 to 60% of the total cost of a thermal network, with direct burial in an open trench (typical depth 0.80 to 1.20 m) being the standard method. For crossings under roads, railways, and watercourses, trenchless methods such as horizontal directional drilling (HDD, up to approx. 150 m) or pipe jacking are used. The quality of construction execution — particularly welding, joint assembly, and trench backfilling — determines the service life of the network over decades, making economic and technical planning inseparable.

Installation Methods

Depending on the terrain, existing infrastructure, and pipe system, different installation methods are used. The three basic variants differ considerably in effort, cost, and area of application.

Above-Ground Installation

In above-ground installation, the pipelines are routed on pedestals, pendulum supports, or pipe bridges. This method is rarely used in Central Europe and is largely limited to industrial sites or power plant premises, where the visual impact is of secondary importance and access to the pipelines for maintenance and inspection is desired.

Points to consider:

  • UV protection: The pipe insulation must be protected against solar radiation, typically by sheet metal cladding or UV-resistant coverings.
  • Corrosion protection: Exposed pipelines are subject to weathering, which requires suitable coatings or claddings.
  • Thermal expansion: Above-ground pipelines can expand freely. Expansion loops or compensators must be planned accordingly.

Underground Installation in Open Trench (Direct Burial)

Direct burial in an open trench is the standard method for thermal networks. It offers a high degree of prefabrication, comparatively low construction effort, and is suitable for most route configurations. The key advantages:

  • Proven method with extensive experience among civil engineering contractors
  • High degree of prefabrication through factory pre-insulated pipe systems (KMR, flexible pipes)
  • Good protection of pipelines against mechanical damage and weathering
  • No impairment of the landscape or urban environment
  • Accessibility for future extensions via branch chambers

The typical trench depth is 0.80 to 1.20 m (top of pipe), depending on frost depth, traffic loading, and local regulations. In road areas with heavy traffic loading, greater cover depth is required.

Trenchless Installation

Where an open trench is not feasible or economically unviable — for example when crossing roads, railway lines, or watercourses — trenchless methods are used.

Horizontal Directional Drilling (HDD): A steered drilling method in which a pilot bore is first created and subsequently enlarged to the required diameter. The pipeline is then pulled in. HDD is suitable for lengths up to approximately 150 m and also permits curved route alignments. It is frequently used for crossing watercourses and traffic routes.

Pipe jacking: A casing pipe is hydraulically pushed through the ground. The actual carrier pipeline is subsequently installed inside the casing pipe. The method is suitable for short distances and diameters up to approximately DN 200. It requires a launch pit and a reception pit.

Inverted siphon (Dueker): Inverted siphons are pipeline sections that pass beneath an obstacle (e.g., a watercourse). They are often constructed as a combination of open excavation and trenchless methods and require special measures regarding tightness and corrosion protection.

Route Planning

Route planning defines the precise alignment of the pipelines in the terrain. It takes into account technical, legal, and economic boundary conditions and has a significant impact on construction costs.

Rigid Pipe Systems

For rigid pre-insulated bonded pipes (KMR) made of steel, changes of direction and thermal expansion must be given particular consideration. Pipe statics require that bends, elbows, and anchor points are arranged such that the thermally induced forces are safely accommodated. A longitudinal profile of the route is mandatory in order to identify high points (venting), low points (drainage), and gradient conditions. Changes of direction are realized either through prefabricated bends or by elastic bending of the pipe string, observing the permissible bending radii.

Flexible Pipe Systems

Flexible pipe systems (e.g., made of PE-Xa or PB with PUR insulation) considerably simplify route planning. Changes of direction can be achieved without separate fittings through natural bending of the pipe. Installation is carried out from the drum, enabling long runs without joints. Expansion problems are significantly less pronounced than with rigid systems due to the material properties.

Approval Procedures

The installation of district heating pipelines in public ground typically requires approval from the responsible municipality or canton. This procedure can — depending on the complexity of the route and the authorities involved — take up to six months. Early coordination with the approval authorities and utility owners is therefore strongly recommended.

Minimum Clearances to Other Utilities

Numerous pipelines and cables run underground, to which defined minimum clearances must be maintained. Typical values according to applicable standards:

UtilityParallel RoutingCrossing
Gas pipelines>= 0.40 m>= 0.20 m
Power cables>= 0.40 m>= 0.20 m
Drinking water pipes>= 0.40 m>= 0.20 m
Telecommunications>= 0.30 m>= 0.20 m

Before the start of construction, utility location information must be obtained. The actual position of existing utilities is ideally verified on site by means of trial trenches.

Common Installation Situations

In practice, different challenges arise depending on the surroundings:

  • Paved surfaces (road areas): Breaking up and restoring the road surface causes considerable costs. Coordination with other utility construction works and with the road owner is necessary. Traffic management and barriers must be planned.
  • Unpaved areas (agricultural land): Installation is simpler and less expensive, but requires careful restoration of the topsoil layer and, where applicable, compensation to landowners.
  • Terrain sections with slopes: Hillside water and ground stability require additional measures such as drainage, shoring, or slope stabilization.
  • Private properties: Routing pipelines across private land requires a contractually secured easement (right of way), which must be registered in the land registry.
  • Subsequent connections: For the later connection of additional consumers, branching points (tees, chambers) should already be provided during initial construction. Subsequent connections to existing pipelines require a service interruption or special procedures (e.g., hot tapping under pressure).

Civil Works — Construction Workflow

Civil works for thermal networks follow a systematic workflow that can be divided into three main phases.

Trench Excavation

The trench is excavated mechanically. The trench width depends on the pipe diameter and the required working space — typically 0.60 to 1.20 m width for single pipelines. From a trench depth of 1.50 m, shoring (struts or trench sheets) is mandatory to protect workers. Two trench profiles are common:

  • Sloped trench: In open areas with sufficient space. The slope gradient depends on the soil type (typically 1:1 to 1:0.5).

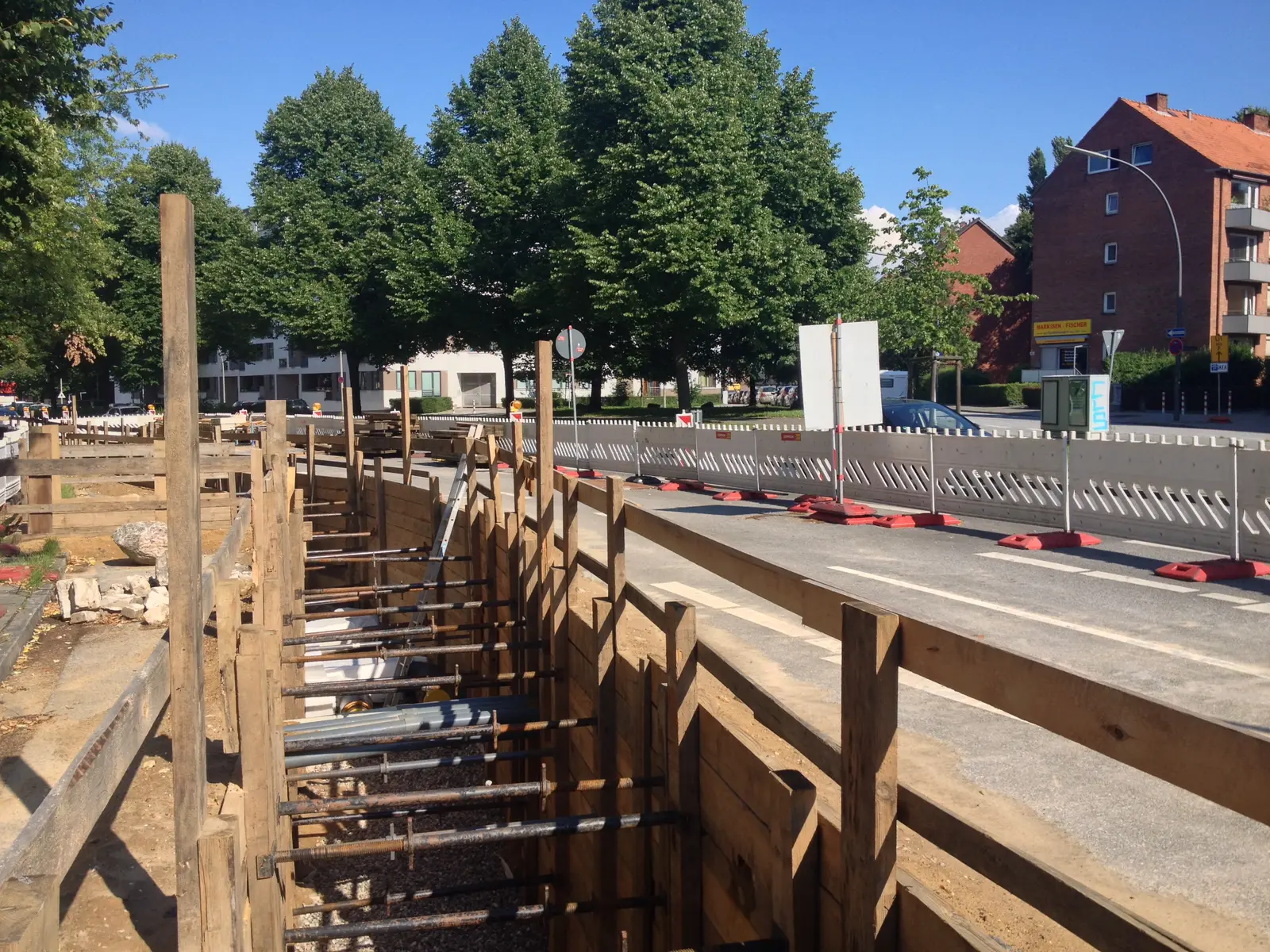

  • Shored (braced) trench: In confined conditions, particularly in road areas. Trench sheets or trench planks secure the trench walls.

Wall penetrations at building connections are made by core drilling and sealed with suitable sealing sleeves.

Pipe Installation

After trench excavation, the actual pipe installation takes place:

  • Welding: Steel pipes are joined by certified welders. The welds are inspected according to applicable standards (e.g., EN 13941), depending on requirements by visual inspection, ultrasonic testing, or radiographic testing.
  • Joint assembly: The joints of pre-insulated pipes (couplings) are filled on site with PUR foam and sealed with shrink sleeves or shrink couplings. This work step is quality-critical — defective joints are the most common cause of damage in district heating networks.
  • Pressure testing: Before backfilling, the entire pipeline is subjected to a pressure test (typically at 1.3 times the operating pressure). Backfilling is only permitted after a successful test.
  • Chambers: At branches, high points (venting), and low points (drainage), chambers are installed to ensure subsequent access for maintenance and operation.

Trench Backfilling

Trench backfilling is carried out in multiple layers and is critical for the long-term protection of the pipelines:

  1. Pipe bedding: The pipelines are surrounded with fine gravel or sand (grain size <= 0.075 mm). This layer protects the insulation from damage by sharp-edged stones and distributes the overburden load evenly. The bedding height is typically 10 to 15 cm above the top of the pipe.
  2. Backfill: The trench is backfilled in layers of 30 to 50 cm thickness with the excavated material or suitable imported material. Each layer is mechanically compacted to prevent subsequent settlement.
  3. Base course and surfacing: In road areas, the pavement structure (base course, binder course, surface course) is professionally restored. Compaction must meet the requirements of the traffic loading.
  4. Surface restoration: Green areas, footpaths, and other surfaces are restored to their original condition. For agricultural land, the layer-by-layer reinstatement of topsoil must be ensured.

Conclusion

Installation and civil works are the most cost-intensive phases in the construction of a thermal network. Early and careful route planning — taking into account approval procedures, existing utilities, and installation methods — lays the foundation for an economical implementation. Professional construction execution, particularly in welding, joint assembly, and trench backfilling, determines the service life of the network over decades. Modern planning software such as VICUS Districts supports route planning through the calculation of optimal pipeline alignments and helps to minimize costs as early as the design phase.

Further reading: Pipe Systems Compared compares the available pipe system families and their suitability for different installation methods, Heat Loss Calculation shows how burial depth and insulation affect network losses, and Planning Phases for Thermal Networks describes when in the planning process the installation method is determined.

References and Standards

  • AGFW FW 401 — Installation and Statics of Pre-insulated Bonded Pipes in District Heating Networks
  • DIN EN 13941 — District Heating Pipes — Design and Installation of Factory-insulated Bonded Pipe Systems

Frequently Asked Questions

How deep are district heating pipes buried?
The typical trench depth is 0.80 to 1.20 m (top of pipe), depending on frost depth, traffic loading, and local regulations. In road areas with heavy traffic, greater cover depth is required. From a trench depth of 1.50 m, shoring is mandatory to protect workers.
What trenchless installation methods are available for district heating?
The main methods are horizontal directional drilling (HDD) for lengths up to approximately 150 m, particularly for crossings under watercourses and roads, and pipe jacking for short distances up to DN 200. Inverted siphons are used to pass beneath obstacles such as watercourses.
How much does civil works cost for a heating network?
Approximately 50 to 60% of the total cost of a thermal network is attributable to pipe installation including civil works. Costs depend heavily on the route: installation in paved road areas is significantly more expensive than in unpaved land due to the cost of breaking up and restoring the road surface.

Disclaimer: The content of this page is for general information purposes only and does not constitute legal, planning or engineering advice. All information is provided without guarantee. Despite careful research, VICUS Software GmbH assumes no liability for the accuracy, completeness or timeliness of the information provided. Third-party product names and trademarks are mentioned for informational purposes only and are the property of their respective owners.
